Shortest Job First (SJF) Scheduling Examples

In the Shortest Job First (SJF) Scheduling in OS the CPU always executes the process with the shortest CPU burst time among all the processes available in the ready queue. This approach reduces the average waiting time and improves overall CPU performance.

In SJF Scheduling

  • The process with the shortest CPU burst time is selected for execution first.
  • If two or more processes have the same burst time, the process with the earlier arrival time is executed first.
  • If both the arrival time and burst time are the same, the process with the smaller process ID (or lower order number) is executed first.
  • SJF can be Non-Preemptive, where a running process continues until completion, or Preemptive (Shortest Remaining Time First – SRTF), where a newly arrived process with a shorter remaining burst time can interrupt the running process.

In this section, we will solve multiple Shortest Job First (SJF) Scheduling examples with Gantt charts, Completion Time (CT), Waiting Time (WT), Turnaround Time (TAT), Response Time (RT), Average Waiting Time (AWT), and Average Turnaround Time (ATAT). We will cover different scenarios, including same arrival time, different arrival times, non-preemptive SJF, preemptive SJF (SRTF), and examples involving I/O operations.

Formulas that will be used in this lecture are given below

  • Completion Time (CT) = Time at which a process completes its execution or exits. We can see in gantt chart.
  • Response Time (RT) = Time at which a process first gets the CPU (Find in Gantt Chart) – Arrival time
  • Turnaround Time (TAT) = Completion Time (CT) − Arrival Time (AT)
  • Waiting Time (WT) = Turnaround Time (TAT) − Burst Time (BT)
  • Average Waiting Time (AWT) = Sum of all Waiting Times (WT) ÷ Total Number of Processes
  • Average Turnaround Time (ATAT) = Sum of all Turnaround Times (TAT) ÷ Total Number of Processes

SJF Scheduling Example: 01

Consider that there are 4 processes (P1, P2, P3, and P4) with their arrival and burst times, which are given in the following diagram

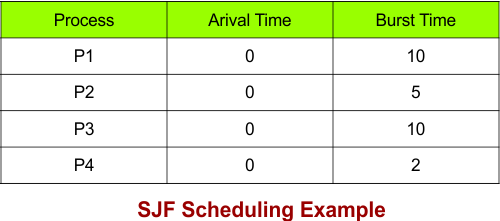

SJF Scheduling Example - 1

By using SJF scheduling, calculate completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time (AWT), and average turnaround time (ATAT).

Solution

Gantt Chart of Example 1 is given below

SJF Scheduling Example 1 - Gantt Chart

All Calculations

The following diagram calculates completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time (AWT), and average turnaround time (ATAT).

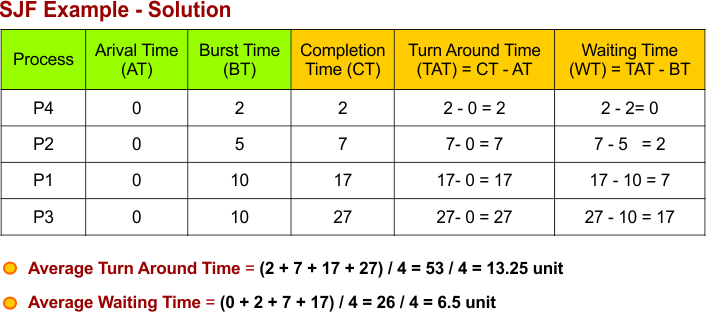

SJF Scheduling Example 1 - Solution

Ready Queue and Gantt Chart Behavior in Example 1

At time 0:

All processes (P1, P2, P3, and P4) enter the ready queue. The CPU scheduler compares their burst times (10, 5, 10, and 2). P4 has the shortest burst time (2 ms), so it is selected first.

SJF Scheduling Example 1 - Ready Queue at time 0

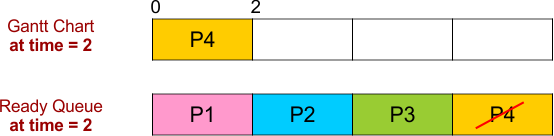

At time 2:

P4 completes its execution at time 2. The Ready Queue contains P1, P2, and P3, where P2 contains shortest burst time among P1, P2, and P3, so now it will be executed by the CPU.

SJF Scheduling Example 1 - Gantt Chart and Ready Queue - 1

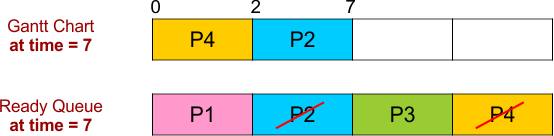

At time 7:

P2 completes its execution at time 7. The Ready Queue contains P1 and P3, where P1 and P2 contains similar burst time and arrival time. But P1 has smaller process ID, so now it will be executed by the CPU.

SJF Scheduling Example 1 - Gantt Chart and Ready Queue - 2

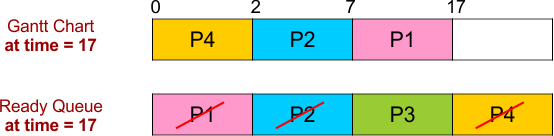

At time 17:

P3 completes its execution at time 17. The Ready Queue contains only P3, so now it will be executed by the CPU.

SJF Scheduling Example 1 - Gantt Chart and Ready Queue - 3

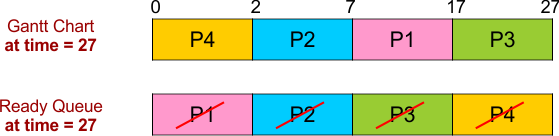

At time 27:

P3 completes its execution at time 27. The Ready Queue contains nothing. That’s all

SJF Scheduling Example 1 - Gantt Chart and Ready Queue -4

SJF Scheduling Example: 02

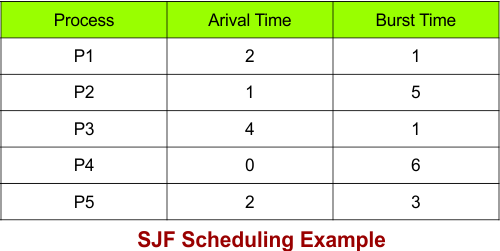

Consider there are 5 processes (P1, P2, P3, P4, and P5) with their arrival and burst times, which are given in the following diagram

SJF Scheduling Examples - 2

By using SJF scheduling, calculate completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time (AWT), average turnaround time (ATAT), and response time (RT).

Solution

Gantt Chart of Example 2 is given below

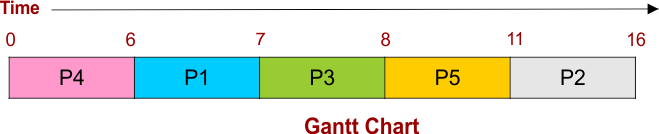

SJF Scheduling Example - 2 Gantt Chart

All Calculations

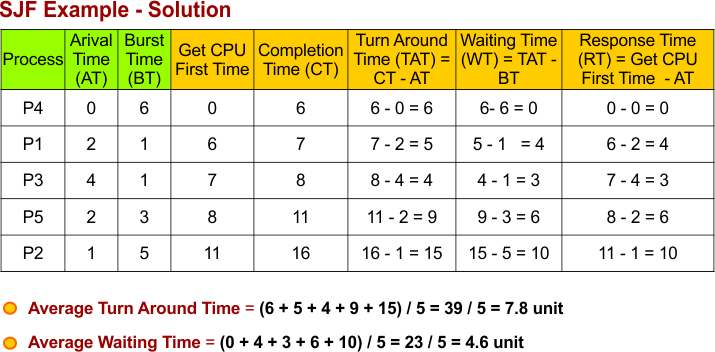

The following diagram calculates completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time (AWT), average turnaround time (ATAT), and response time.

SJF Scheduling Example - 2 Solution completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time

SJF Scheduling Example: 03

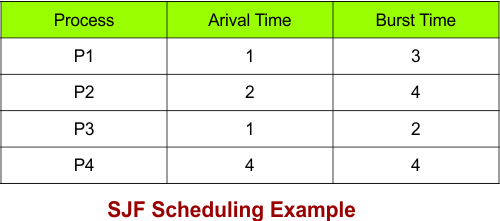

Consider there are 4 processes (P1, P2, P3, and P4) with their arrival and burst times, which are given in the following diagram

SJF Scheduling Example - 3

Using SJF scheduling, calculate the completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time (AWT), and average turnaround time (ATAT).

Solution

Gantt chart for Example 3 is given below

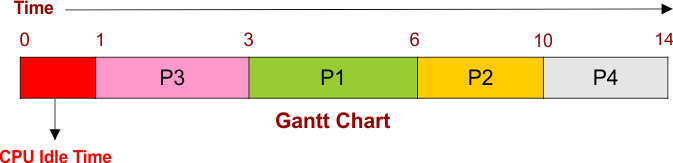

SJF Scheduling Example - 3 Gantt Chart

All Calculations

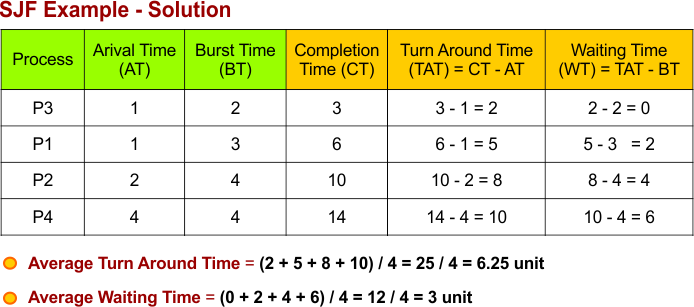

The following diagram calculates completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time (AWT), and average turnaround time (ATAT).

SJF Scheduling Example - 3 Solution completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time

SJF Scheduling Example: 04

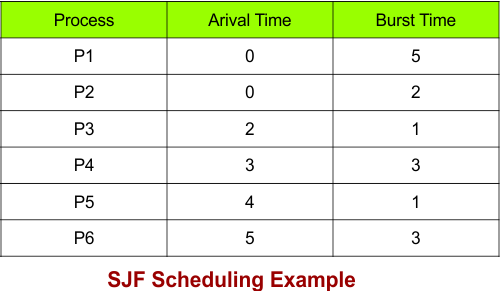

Consider there are 4 processes (P1, P2, P3, P4, P5 and P6) with their arrival and burst times, which are given in the following diagram

SJF Scheduling Example - 4

Using SJF scheduling, calculate the completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time (AWT), and average turnaround time (ATAT).

Solution

Gantt chart for Example 4 is given below

SJF Scheduling Example - 4 Gantt Chart

All Calculations

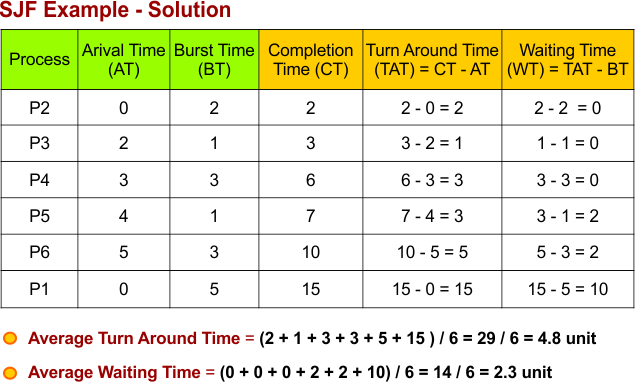

The following diagram calculates completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time (AWT), and average turnaround time (ATAT).

SJF Scheduling Example - 4 Solution completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time

SJF Scheduling Example: 05

Consider there are 5 processes (P1, P2, P3, P4, and P5) with their arrival and burst times, which are given in the following diagram

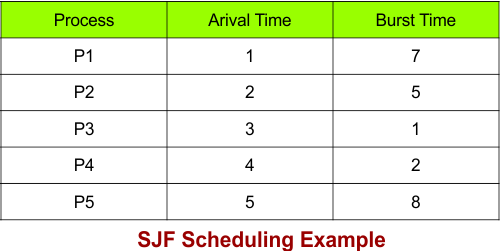

SJF Scheduling Example - 5

Using SJF scheduling, calculate the completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time (AWT), and average turnaround time (ATAT).

Solution

Gantt chart for Example 5 is given below

SJF Scheduling Example - 5 Gantt Chart

All Calculations

The following diagram calculates completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time (AWT), and average turnaround time (ATAT).

SJF Scheduling Example - 5 Solution completion time (CT), waiting time (WT), turnaround time (TAT), average waiting time
